New and Renewable Energy Facilities
- home
Business
Domestic
New and Renewable Energy Facilities
KOMIPO builds and operates facilities using various renewable energy sources, including PV, wind, biofuel, fuel cell, small hydropower, marine energy, and more.It implements a renewable portfolio standard (RPS) and greatly contributes to the reduction of GHG emissions.
It is leading the development of new renewable energy projects in rapidly changing energy market, centering around the four major power sources, wind, bio and photovoltaic power as well as fuel cell, to use them for power generation in constantly developed new projects.

Action plan and goals for facility expansion
-
Present
-
Facility capacity :
985MWInvestment :
KRW 509.2billionRPS compliance :
10,503,000REC
-
2030goal
-
Facility capacity :
2,915MWInvestment :
KRW 2,094.5billionRPS compliance :
18,207,000REC
-
3UPstrategy
-
-
Massive expansion of business development
-
50+ MW photovoltaics and onshore wind power, and 100+ MW offshore wind power projects
-
-
Acceleration of business development
-
Preoccupation of areas for renewable energy projects
-
Reinforcement of capacity for business development
-
-
Discovery of localcommunity-friendly business models
-
Participation of local residents and profit sharing
-
Construction of complex sites associated with tourist regions
-
-

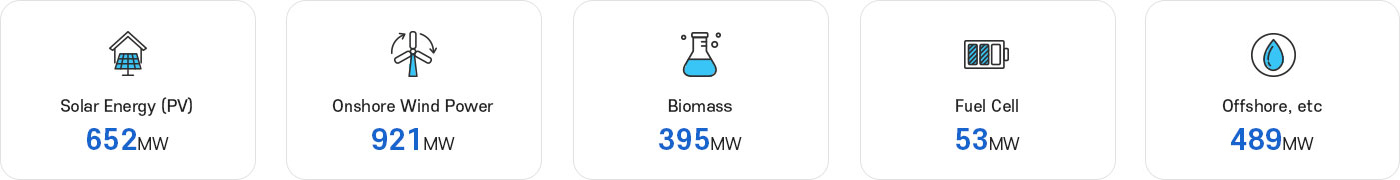

Development plan for each energy source(2030)
-
Photovoltaics
1,091MW
-
Onshore wind
577MW
-
Offshore wind power
990MW
-
Bio
160MW
-
Fuel cell
82MW
-
Small hydro
15MW
-
Carbon-free energy source, etc.
1,920MW

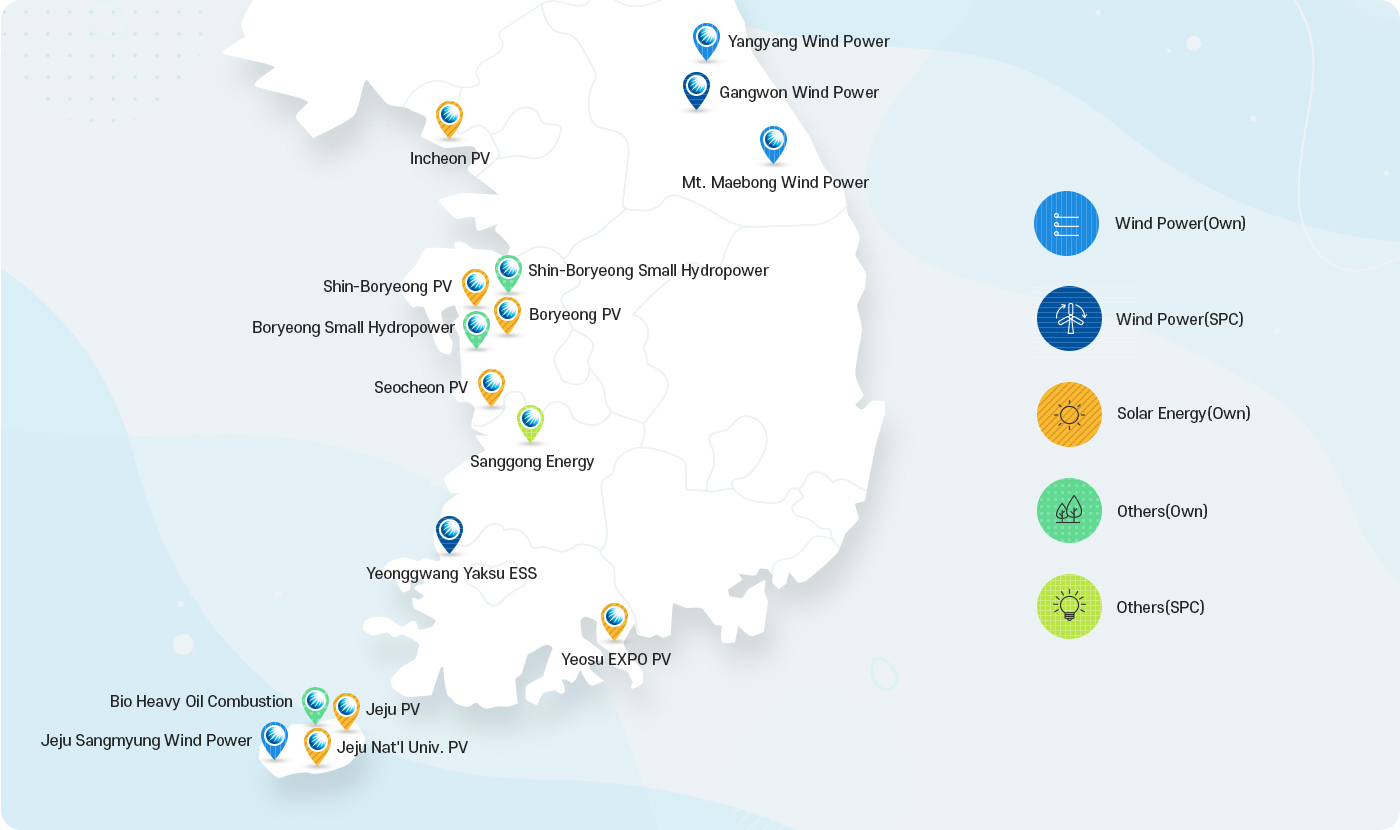

Domestic Operating Facilities
scroll
Category | Facility | Location | Capacity | Note | |
---|---|---|---|---|---|
PV(KOMIPO) | Photovoltaics | Seocheon PV | Seocheon-gun, Chungcheongnam-do | 1.2MW | In operation |
Boryeong PV | Boryeong-si, Chungcheongnam-do | 1.96MW (0.53MW+0.04MW+0.94MW+0.45MW) |
In operation | ||
Seoul PV | Seoul | 1.3MW | In operation | ||
Incheon PV | Incheon | 1.57MW (0.3MW + 0.95MW + 0.32MW) | In operation | ||
Yeosu EXPO PV | Yeosu-si, Jeollanam-do | 2.2MW | In operation | ||
Jeju National University PV | Jeju-si, Jeju-do | 1.1MW | In operation | ||
Jeju PV | Jeju-si, Jeju-do | 1.15MW | In operation | ||
Shin Boryeong PV | Boryeong-si, Chungcheongnam-do | 4.07MW(2.9MW+1.17MW) | In operation | ||
Boryeong Floating PV | Boryeong-si, Chungcheongnam-do | 1.17MW | In operation | ||
Sejong Rooftop PV | Sejong | 0.3MW | In operation | ||
Jeju Seongeup-ri PV | Seogwipo-si, Jeju-do | 2MW(1MW+1MW) | In operation | ||
ESS | Sonae PV | 8 locations(incl. Shin Boryeong) | PCS 8.5MW, BAT 27.9MWh | In operation | |
PV (SPC) | Photovoltaics | Highway PV(stage 1) | 40 locations(incl. rooftopof Korea Expressway Corporation Goseong Office) | 22MW | In operation |
Yeonggwang PV | Yeonggwang PV Yeonggwang-gun, Jeollanam-do | 100MW | In operation | ||
Muan PV | Muan-gun, Jeollanam-do | 33MW | In operation | ||
Goesan PV | Goesan-gun, Chungcheongbuk-do | 15MW | In operation | ||
Gunsan Eoeun-ri PV | Gunsan-si, Jeonbuk-do | 30MW | In operation | ||
Yeongyang Ogi-ri PV | Yeongyang-gun, Gyeongsangbuk-do | 6MW | In operation | ||
Rooftop PV for SMEs | Sacheon-si, Gyeongsangnam-do, etc. 15 SMEs | 10MW | In operation | ||
Saemangeum Zone 3 PV | Gunsan-si, Jeonbuk-do | 99MW | In operation | ||
ESS | Yeonggwang PV | Yeonggwang-gun, Jeollanam-do | PCS 87MW, BAT 312MWh | In operation | |
Muan PV | Muan-gun, Jeollanam-do | PCS 30MW, BAT 110MWh | In operation | ||
Goesan PV | Goesan-gun, Chungcheongbuk-do | PCS 13.5MW, BAT 40MWh | In operation | ||
Wind(KOMIPO) | Wind Power | Yangyang Wind Farm | Yangyang-gun, Gangwon-do | 3.0MW (1.5MW x 2units) | In operation |
Maebongsan Wind | Taebaek-si, Gangwon-do | 8.8 MW(0.85 MW x 8 units + 2 MW x 1unit) | In operation | ||
Sangmyeong Wind | Hallim-eup, Jeju-si, Jeju-do | 21MW (3MW x 7units) | In operation | ||
ESS | Sangmyeong Wind | Hallim-eup, Jeju-si, Jeju-do | PCS 2MW, BAT 7.3MWh | In operation | |
Wind (SPC) | Wind Power | GangwonWind Farm | Pyeongchang-gun, Gangwon-do | 98MW (2MW x 49units) | In operation |
Yeonggwang Yaksu Wind Farm | Yeonggwang-gun, Jeollanam-do | 19.8MW (3.3MW x 6units) | In operation | ||
Jeju Gimnyeong Wind Farm | Jeju-si, Jeju-do | 30MW (3MW x 10units) | In operation | ||
Geumbong Wind | Taebaek-si, Gangwon-do | 28MW (4MW x 7units) | In operation | ||
Yangsan Yeomsubong Wind | Yangsan-si, Gyeongsangnam-do | 15.6MW(5.2MW x 3units) | Under construction | ||
Yeongyang Wind Unit 2 | Yeongyang-gun, Gyeongsangbuk-do | 42MW (4.2MW x 10units) | In operation | ||
Yeongdeok Haeparang Wind | Yeongdeok-gun, Gyeongsangbuk-do | 16.68MW(5.56MW x 3units) | Under construction | ||
Seo Namhae Offshore Wind Farm | Offshore from Buan-gun, Jeonbuk-do to Gochang-gun, Jeonbuk-do | 60MW (3.3MW x 6units) | In operation | ||
Jeju Hallim Offshore Wind Farm | Jeju-si, Jeju-do | 100MW (5.56MW x 18units) | Under construction | ||
ESS | Yeonggwang Yaksu ESS | Yeonggwang-gun, Jeollanam-do | PCS 4MW, BAT 12MWh | In operation | |
Other (KOMIPO) | Wood Pellet Co-firing(Boryeong Units 3 to 8) | Boryeong-si, Chungcheongnam-do | 100MW | In operation | |
Organic Solid Fuel Co-firing (Boryeong Units 7 and 8) |
Boryeong-si, Chungcheongnam-do | 50MW | In operation | ||
Bioheavy Oil Power Plant (Jeju Steam Units 2 and 3) |
Jeju-si, Jeju-do | 150MW | In operation | ||
Boryeong Small Hydropower Plant | Boryeong-si, Chungcheongnam-do | 7.5MW (1.25MW x 6Units) | In operation | ||
Shin Boryeong Small Hydro | Boryeong-si, Chungcheongnam-do | 5MW(2.5MW x 2Units) | In operation | ||
Shin Seocheon Small Hydro | Seocheon-gun, Chungcheongnam-do | 2.6MW | In operation | ||
Boryeong Fuel Cell Unit 2 (formerly ShinBoryeong Fuel Cell) |
Boryeong-si, Chungcheongnam-do | 7.5MW | In operation | ||
Incheon Fuel Cell | Incheon | 31.6MW (15.8MW x 2Units) | In operation | ||
Sejong Fuel Cell | Sejong | 5.3MW | In operation | ||
Seoul Fuel Cell | Seoul | 6MW | In operation | ||
Other(SPC) | Sanggong Energy | Iksan-si, Jeonbuk-do | 9.8MW | In operation | |
Gwangju Sangmu Complex Fuel Cell | Gwangju | 12.32MW | In operation |
KOMIPO aims at developing eco-friendly wind power business to 6 GW of offshore wind power and 1 GW of onshore wind power by 2030.
In particular, it is actively enhancing its independent O&M technology and sharing profits with local communities centering around the massive offshore wind power projects.
KOMIPO facilities
-
Jeju Sangmyeong Wind Farm
-
Location :
Hallim-eup, Jeju-si, Jeju-do
-
Capacity :
21 MW (3 MW x 7 units) + ESS(PCS 2 MW, BAT 7.3 MWh)
-
Type :
Horizontal axis propeller type
-
Construction :
Aug. 2016
-
Investment :
KRW 54.1 billion
-
-
Yangyang Wind Farm
-
Location :
Yangyang Pumped Storage Power Plant inYangyang-gun, Gangwon-do
-
Capacity :
3.0MW (1.5MW x 2units)
-
Type :
Horizontal axis propeller type
-
Construction :
Jun. 2006
-
Investment :
KRW 5.8 billion
-
Joint investment facilities
-
Gangwon Wind Farm
-
Location :
Pyeongchang-gun, Gangwon-do
-
Capacity :
98 MW (2 M x 49 units)
-
Type :
Horizontal axis propeller type
-
Construction :
Oct. 2006
-
Project type :
Build-Own-Operate (BOO)
-
Expenses(share) :
KRW 158.8 billion (15%)
-
-
Yeonggwang Yaksu Wind Farm
-
Location :
Yeonggwang-gun, Jeollanam-do
-
Capacity :
19.8MW(3.3MW x 6units)
-
Type :
Horizontal axis propeller type
-
Construction :
Nov. 2016
-
Expenses(share) :
KRW 55.3 billion (9.6%)
-
-
Seo Namhae Offshore Wind Power(Pilot)
-
Location :
Offshore in Buan-gun and Gochang-gun, Jeonbuk-do
-
Capacity :
60MW(3MW x 20units)
-
Type :
Horizontal axis propeller type
-
Construction :
Jan. 2020
-
Expenses(share) :
KRW 457.3 billion (12.5%)
-
-
Jeju Gimnyeong Wind Farm
-
Location :
Gujwa-eup, Jeju-si, Jeju-do
-
Capacity :
30MW(3MW x 10units)
-
Type :
Horizontal axis propeller type
-
Construction :
Jun. 2015
-
Expenses(share) :
KRW 83 billion (30%)
-
-
Taebaek Geumbong Wind Farm
-
Location :
Changjuk-dong, Taebaek-si, Gangwon-do
-
Capacity :
28MW(4MW x 7units)
-
Type :
Horizontal axis propeller type
-
Construction :
Dec. 2022
-
Expenses(share) :
KRW 81,990 million (29%)
-
-
Yeongyang Wind Unit 2
-
Location :
Samui-ri, Seokbo-myeon,Yeongyang-gun, Gyeongsangbuk-do
-
Capacity :
42MW(4.2MW x 10units)
-
Type :
Horizontal axis propeller type
-
Construction :
Sep. 2023
-
Expenses(share) :
KRW 121.1 billion (30%)
-
New developments
-
Jeju Hannim Offshore Wind Farm
-
Location :
Hannim-eup, Jeju-si
-
Capacity :
100MW(5.56MW x 18units)
-
Construction :
Jan. 2022 ~ February. 2025
-
Partners :
KOMIPO, KEPCO, KEPCO E&C, Hyundai E&C, Baram
-
Expenses :
KRW 630.3 billion
-
-
Yeongdeok Haeparang Wind
-
Location :
Goesi-ri, Yeonghae-myeon, Yeongdeok-gun,Gyeongsangbuk-do
-
Capacity :
16.68MW(5.56MW x 3units)
-
Construction :
Jul. 2022 ~ Jun. 2024
-
Partners :
KOMIPO, Total Eren, Ween E&S
-
Expenses :
KRW 64 billion
-
-
Yangsan Yeomsubong Wind
-
Location :
Wondong-myeon, Yangsan-si,Gyeongsangnam-do
-
Capacity :
15.6MW(5.2MW x 3units)
-
Construction :
Aug. 2022 ~ Dec. 2024
-
Partners :
KOMIPO, Pungbaek Green Energy
-
Expenses :
KRW 55.9 billion
-
-
Pyeongchang Hoenggye Eco Wind
-
Location :
Hoenggye-ri, Daegwallyeong-myeon, Pyeongchang-gun,Gangwon-do
-
Capacity :
40MW
-
Partners :
KOMIPO, Taehwan, Hanwha Solutions
-
Expenses :
KRW 106 billion
-
-
Gochang Offshore Wind Power
-
Location :
Haeri-myeon and Sangha-myeon, Gochang-Gun, Jeollanam-do
-
Capacity :
76.2 MW
-
Construction :
March. 2025 ~ August. 2028
-
Partners :
KOMIPO, DNI Corporation, Sanil Electronic
-
Expenses(share) :
KRW 383.5 billion
-
-
Tongyeong Yokji Offshore Wind Power
-
Location :
Yokjido , Tongyeong-si, Gyeongsangnam-do
-
Capacity :
384 MW
-
Construction :
August. 2028 ~ January. 2031
-
Partners :
KOMIPO, Vena Energy
-
Expenses(share) :
KRW 2.1 trillion
-
-
Boryeong Nokdo Offshore Wind Power
-
Location :
Nokdo-ri, Ocheon-myeon, Boryeong-si, Chungcheongnam-do
-
Capacity :
320 MW
-
Construction :
July. 2029 ~ November. 2031
-
Partners :
KOMIPO, Hanhwa E&C
-
Expenses(share) :
KRW 2.605 trillion
-
-
Public-led Incheon 2 Offshore Wind Power
-
Location :
Deokjeokdo, Ongjin-Gun, Incheon-si
-
Capacity :
800 MW
-
Construction :
June. 2030 ~
May. 2033 -
Partners :
KOMIPO
-
Expenses(share) :
KRW 6 trillion
-
-
Public-led Boryeong Offshore Wind Power
-
Location :
Oeyeondo and Hodo, Boryeong-si, Chungcheongnam-do
-
Capacity :
1,005 MW
-
Construction :
June. 2030 ~
June. 2033 -
Partners :
KOMIPO(Undecided)
-
Expenses(share) :
KRW 6.532 trillion
-
-
Seo Namhae Offshore Wind Power(Demonstration)
-
Location :
Wido, Buan-Gun, JeollaBuk-do
-
Capacity :
400 MW
-
Construction :
January. 2027 ~ December. 2030
-
Partners :
KOMIPO, KEPCO, 5 Gen. Corps
-
Expenses(share) :
KRW 2.5882 trillion
-
KOMIPO is constructing and operating PV facilities generating a total of 448MW (KOMIPO projects: 32MW, SPC projects: 416MW, including ESS) to further develop its PV business under the slogan “Photovoltaic 3-Way Project.”Projects are ongoing three ways: land PV projects using idle sites, floating PV projects using reservoirs and ponds, and rooftop PV projects using buildings.
KOMIPO facilities
-
Boryeong Power Plant Unit 1
-
Location :
Rooftop of the turbine buildings of Boryeong P.G. Site Div. Units 1 & 2, behind the parking lot of the new building
-
Capacity :
526kW
-
Construction :
Apr. 2008
-
Investment :
KRW 3,250 million
-
-
Boryeong Power Plant Unit 2
-
Location :
Boryeong P.G. Site Div. Energy World
-
Capacity :
46.2kW
-
Construction :
Apr. 2009
-
Investment :
KRW 390 million
-
-
Boryeong Power Plant Unit 3
-
Location :
Rooftop of Boryeong P.G. SiteDiv. Unit 3 Turbine Building and old building
-
Capacity :
937.95kW
-
Construction :
Dec. 2018
-
Investment :
KRW 1,280 million
-
-
Boryeong Power Plant Unit 4
-
Location :
Parking lot behind the old building and KOMIPO Institute of Technology of Boryeong P.G. SiteDiv., and new parking lot
-
Capacity :
454.35kW
-
Construction :
Mar. 2019
-
Investment :
KRW 580 million
-
-
Boryeong Floating PV
-
Location :
Water surface of intake canal at Boryeong P.G. Site Div.
-
Capacity :
1,171.8kW
-
Construction :
Aug. 2017
-
Investment :
KRW 1,980 million
-
-
Shin Boryeong PV
-
Location :
Rooftop of Shin Boryeong P.G.Site Div. Coal Yard
-
Capacity :
2,903.04kW
-
Construction :
Aug. 2016
-
Investment :
KRW 5,130 million
-
-
Shin Boryeong PV Unit 2
-
Location :
Parking lot of Shin Boryeong P.G.Site Div. Main Building, and southern road
-
Capacity :
1,170.12kW
-
Construction :
Jul. 2022
-
Investment :
KRW 2.9 billion
-
-
Seocheon PV Unit 1
-
Location :
Idle site at Shin Seocheon P.G.Site Div.
-
Capacity :
1,202kW
-
Construction :
Jan. 2008
-
Investment :
KRW 8,640 million
-
-
Yeosu EXPO PV
-
Location :
Yeosu EXPO Energy Park inYeosu-si, Jeollanam-do
-
Capacity :
2,218.67kW
-
Construction :
Mar. 2012
-
Investment :
KRW 6,990 million
-
-
Shin Seocheon PV Units 1 & 2
-
Location :
Idle site at Shin Seocheon P.G. SiteDiv.
-
Capacity :
1,998.12kW / 625.6kW
-
Construction :
Oct. 2022
-
Investment :
KRW 4,590 million
-
-
Incheon PV Unit 1
-
Location :
Rooftop of Incheon P.G. SiteDiv. Environmental & ChemicalEngineering Team and warehouse
-
Capacity :
304kW
-
Construction :
Dec. 2011
-
Investment :
KRW 1,010 million
-
-
Incheon PV Unit 2
-
Location :
Upper region of intake canal atIncheon P.G. Site Div., and rooftop of wastewater treatment building
-
Capacity :
950.16kW
-
Construction :
Jan. 2019
-
Investment :
KRW 1,670 million
-
-
Incheon PV Unit 3
-
Location :
Rooftop of Incheon P.G. Site Div.Heat Supply Facility Building
-
Capacity :
320.76kW
-
Construction :
Dec. 2019
-
Expenses :
KRW 430 million
-
-
Seoul Seonam PV
-
Location :
Seoul Water Recycling Corporation in Gangseo-gu, Seoul
-
Capacity :
1,301.34kW
-
Construction :
Aug. 2011
-
Investment :
KRW 4,780 million
-
-
Sejong Rooftop PV
-
Location :
Rooftop of Sejong P.G. Site Div.Turbine Building and warehouse
-
Capacity :
327.31kW
-
Construction :
Dec. 2017
-
Investment :
KRW 700 million
-
-
Jeju PV Unit 2
-
Location :
Idle site at Jeju P.G. Site Div.
-
Capacity :
1,149.2kW
-
Construction :
Jan. 2014
-
Investment :
KRW 2,460 million
-
-
Jeju National University PV
-
Location :
Rooftop of Jeju National University in Jeju-si, Jeju-do
-
Capacity :
1,086.8kW
-
Construction :
May 2012
-
Investment :
KRW 3,930 million
-
-
Jeju Seongeup-ri PV Units 1 & 2
-
Location :
Seongeup-ri, Pyoseon-myeon,Seogwipo-si, Jeju-do
-
Capacity :
999.6kW / 999.6kW
-
Construction :
Nov. 2021
-
Investment :
KRW 3,250 million (KRW 1,630million + KRW 1,620 million)
-
-
KOMIPO PV-linked ESS
-
Location :
8 locations (incl. Boryeong P.G.Site Div., Incheon P.G. Site Div.,Yeosu EXPO)
-
Capacity :
(PCS) 8.5MW, (BAT) 28MWh
-
Construction :
May 2020
-
Partners :
Internal project
-
Expenses :
KRW 19,230 million
-
Joint investment facilities
-
Saemangeum Zone 3 PV
-
Location :
Public Waters District 3 in Osikdo-dong, Gunsan-si, Jeonbuk-do
-
Capacity :
99MW
-
Construction :
Apr. 2021 ~ Mar. 2022
-
Expenses(share) :
KRW 160.7 billion (41.1%)
-
-
Rooftop PV for SMEs
-
Location :
15 SMEs (incl. in Nonsan-si,Chungcheongnam-do)
-
Capacity :
10MW
-
Construction :
Jun. 2021 ~ Nov. 2023
-
Expenses(share) :
KRW 11 billion (20%)
-
-
Gunsan Eoeun-ri PV
-
Location :
Eoeun-ri, Okgu-eup, Gunsan-si,Jeonbuk-do
-
Capacity :
30MW
-
Construction :
Feb. 2021 ~ Nov. 2021
-
Expenses(share) :
KRW 57.2 billion (29%)
-
-
Solar School Plant
-
Location :
Rooftops of all schools nationwide
-
Capacity :
110MW
-
Construction :
since 2016
-
Expenses(share) :
KRW 200 billion (8.325%)
-
New developments
-
Seokmunho Reservoir Floating PV
-
Location :
Seongmun-myeon and Songsan-myeon, Dangjin-si, Chungcheongnam-do
-
Capacity :
72MW
-
Construction :
Jul. 2024 ~ Oct. 2025
-
Partners :
KOMIPO, Hanwha Impact
-
Expenses :
KRW 161 billion
-
-
Follow-up Rooftop PV for SMEs
-
Location :
Rooftops of SME buildings inGyeonggi Pyeongtaek IndustrialComplex
-
Capacity :
90MW
-
Construction :
since Mar. 2024
-
Partners :
KOMIPO, Enel X Korea
-
Expenses :
KRW 127.5 billion
-
New R&D
-
ESS Water Cooling Type HeatControl R&D
-
Development :
Dec. 2022 ~ Mar. 2025
-
Partners :
KOMIPO, Ajou University,
Young Hwa Tech Co., Ltd. -
Expenses :
KRW 1 billion
-
KOMIPO facilities
-
Wood Pellet Co-firing (Boryeong Units 1 to 8)
-
Location :
Boryeong P.G. Site Div. in Boryeong-si,Chungcheongnam-do
-
Capacity :
150MW
-
Construction :
Dec. 2013 (Units 3 to 6) & Oct. 2017(Units 1, 2, 7, and 8)
-
Expenses :
KRW 12.2 billion
-
-
Organic Solid Fuel Co-firing(Boryeong Units 7 and 8)
-
Location :
Boryeong P.G. Site Div. inBoryeong-si, Chungcheongnam-do
-
Capacity :
50MW
-
Construction :
Jul. 2021
-
Expenses :
KRW 5.1 billion
-
-
Bioheavy Oil (Jeju Steam Units 2 and 3)
-
Location :
Jeju P.G. Site Div. in Jeju-si,Jeju-do
-
Capacity :
150MW
-
Construction :
May 2019
-
Expenses :
KRW 1.1 billion
-
Replacement :
Bunker C → bioheavy oil fuel
-
-
Shin Boryeong Fuel Cell
-
Location :
Boryeong P.G. Site Div. in Boryeong-si,Chungcheongnam-do
-
Capacity :
7.48MW
-
Type :
LNG(PAFC)
-
Construction :
Dec. 2017
-
Expenses :
KRW 38.3 billion
-
-
Incheon Fuel Cell (stage 1)
-
Location :
Incheon P.G. Site Div. in Incheon
-
Capacity :
15.84MW
-
Type :
LNG(PAFC)
-
Construction :
Feb. 2020
-
Expenses :
KRW 80 billion
-
-
Incheon Fuel Cell (stage 2)
-
Location :
Incheon P.G. Site Div. inIncheon
-
Capacity :
15.84MW
-
Type :
LNG(PAFC)
-
Construction :
Jul. 2022
-
Expenses :
KRW 80 billion
-
-
Sejong Fuel Cell
-
Location :
Sejong P.G. Site Div. in Sejong
-
Capacity :
5.28MW
-
Type :
LNG(PAFC)
-
Construction :
Feb. 2020
-
Expenses :
KRW 26.4 billion
-
-
Seoul Fuel Cell
-
Location :
Seoul P.G. Site Div. in Seoul
-
Capacity :
6MW
-
Type :
LNG(SOFC)
-
Construction :
Oct. 2020
-
Expenses :
KRW 38 billion
-
Joint investment facilities
-
Sanggong Energy
-
Location :
Iksan-si, Jeonbuk-do
-
Capacity :
9.8MW
-
Construction :
Jul. 2021
-
Project type :
Build-Own-Operate (BOO)
-
Expenses(share) :
KRW 106.8 billion (85%)
-
-
Fuel Cell Generation Project in Gwangju Sangmu Complex
-
Location :
Idle site in sewage treatmentplant in Chipyeong-dong, Seo-gu,Gwangju
-
Capacity :
12.32MW
-
Construction :
Dec. 2021
-
Expenses(share) :
KRW 81.5 billion (29%)
-
